If you've sourced plastic parts for consumer products before and you're now buying for an automotive program, you've probably already noticed the paperwork multiplies. That's not bureaucracy for its own sake. Automotive plastic parts sit inside a supply chain where a dimensional drift of a few tenths of a millimeter, or a batch of resin with the wrong flow index, can shut down an OEM's assembly line. The documentation exists because the cost of a failure is so much higher than in most consumer goods.
This guide walks through what makes automotive sourcing different, what PPAP actually asks of a supplier, the honest difference between "PPAP-ready" and "IATF 16949 certified," and what a realistic tooling timeline looks like when you're buying molds from a Chinese manufacturer.
A dashboard clip, a door panel bracket, or a trim piece may look like a simple injection molded part, but it's usually tied to three things that consumer parts rarely need to prove:
Dimensional and functional validation — automotive parts often mate with metal stampings, other plastic components, and moving assemblies, so tolerances and fit/function checks tend to be more rigorous than a typical consumer housing.
Supply chain traceability — OEMs and Tier 1s need to know which mold, which shift, which material lot, and sometimes which cavity produced a given part, especially after a field issue.
Documented process control — rather than relying on a supplier's word that "the process is stable," the buyer wants to see the control plan and inspection data that prove it.
None of this means automotive parts are always more complex geometrically. It means the burden of proof is higher, and that burden is largely satisfied through PPAP.
PPAP, or Production Part Approval Process, is the framework many automotive customers use to confirm a supplier can produce parts that meet requirements, consistently, before mass production starts. If you haven't dealt with it before, here's what to generally expect a supplier to prepare — described at a high level, since exact requirements and submission levels vary by customer and program:
Part Submission Warrant (PSW) — a summary document where the supplier declares the part meets the drawing/specification, and states the submission level and reason for submission.
Dimensional results — actual measured values against the drawing, typically covering all critical dimensions, not just a sample of them.
Material and performance test results — certificates or lab reports showing the resin and part meet specified material and performance requirements.
Control plan — a document describing how the process will be monitored during production, including inspection frequency and reaction plans if something drifts.

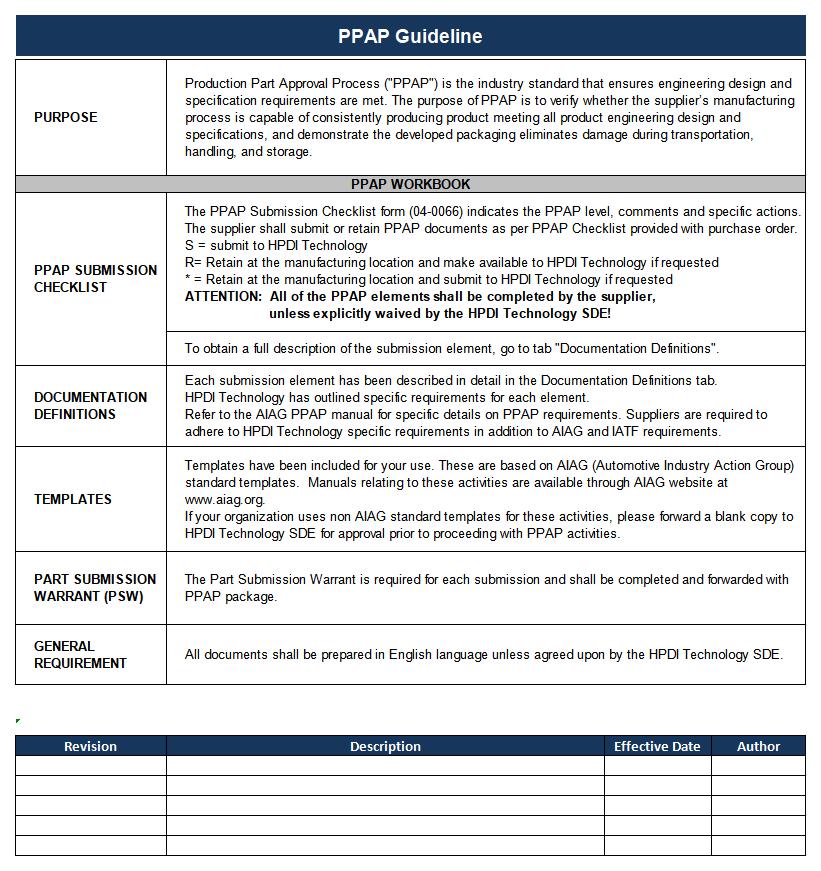

There are other elements a full PPAP package can include, such as process flow diagrams, FMEA, and capability studies, but the four above are the ones a buyer should expect to see referenced early in a conversation with a prospective supplier. If a supplier has never heard of a PSW or can't describe how they'd generate dimensional data against your drawing, that's worth noting before you commit tooling budget.
Ask your supplier directly which PPAP level and which specific elements your program requires — this varies by OEM and by part criticality, and a supplier who asks you this question back (rather than guessing) is usually the more experienced one.
This is a place where buyers get misled, sometimes without the supplier intending to mislead them. "PPAP-ready" and "IATF 16949 certified" are not the same claim, and it's worth being precise about the difference.
IATF 16949 is a formal, third-party-audited quality management system standard specific to the automotive industry. A supplier either holds a current certificate from an accredited certification body, or they don't.
Supporting PPAP submissions and IATF 16949 customer requirements means a supplier has the documentation practices, measurement capability, and process discipline to help you complete a PPAP package and meet the expectations that typically accompany IATF 16949-governed supply chains — without the supplier itself holding the certificate.
To be transparent about where Abery stands: Abery holds ISO 9001:2015 certification, and our quality processes are built to support PPAP submissions and IATF 16949 customer requirements for programs that need them. We do not claim IATF 16949 certification, and you should be cautious of any supplier who implies certification status without being able to produce a current, verifiable certificate. If IATF 16949 certification of the mold-making facility itself is a hard requirement for your program, ask for the certificate number and verify it directly with the certification body — don't take a website claim at face value, from us or anyone else.
Claim | What it actually means | What to ask for |
"ISO 9001:2015 certified" | Facility has a certified general quality management system | Certificate number, issuing body, expiry date |
"Supports PPAP / IATF 16949 requirements" | Supplier can produce PPAP documentation and work within IATF-aligned customer processes | A sample PSW or control plan from a past program |
"IATF 16949 certified" | Facility itself holds an audited automotive-specific QMS certificate | Certificate number, issuing body, scope of certification |

For standard consumer parts, Abery's typical mold development lead time runs 2-5 weeks depending on complexity, with a T1 first-trial followed by a T2 second trial as our standard double-trial policy to confirm the tool is producing to spec before we call it done. Automotive programs generally follow the same core tooling process, but buyers should plan for some additional steps layered on top:
Extra validation trials. Beyond T1 and T2, an automotive program may need additional trial rounds tied specifically to PPAP submission — for example, a trial run specifically to generate the dimensional and capability data the PSW package requires.
Longer internal customer approval cycles. The mold itself might be ready, but your own PPAP submission and OEM sign-off process can add time that has nothing to do with the toolmaker's schedule.
Material qualification lead time. If your program specifies a particular resin grade with its own certification or lot-traceability requirements, sourcing and qualifying that material can run in parallel with tooling, but it needs to be started early.
The honest takeaway: the mold build itself doesn't necessarily take dramatically longer for an automotive part than a consumer part of similar complexity, but the total program timeline — tooling plus validation plus approval — usually does. Build that into your program schedule rather than assuming tooling lead time alone.
One of the more common (and stressful) situations in automotive sourcing is inheriting a program from a supplier who failed to deliver. Abery's case study on Interior Trim Parts — Transfer From Failed Supplier, 60-Day Recovery reflects exactly this scenario: an automotive interior trim program needed to move to a new tooling partner and get back into production within a compressed window. Situations like this test a supplier's ability to reverse-engineer or validate existing tooling data, requalify the process, and move quickly without cutting corners on documentation — which is exactly the combination automotive buyers should be screening for even when things are going well, not just during a crisis.
Material selection for automotive trim depends heavily on the specific application — UV exposure, temperature range, impact requirements, and whether the part is interior (softer touch, cosmetic finish, lower heat exposure) or exterior (UV stability, weathering, impact resistance). In general terms, the categories commonly discussed for these applications include:
Engineering thermoplastics such as ABS and PC/ABS blends for interior trim components
Polypropylene (PP) compounds, often talc- or glass-filled, for structural or semi-structural trim parts
Impact-modified or UV-stabilized grades for exterior-facing components
This is a general industry overview, not a specification. The right material and grade for your part depends on your performance requirements, and you should confirm the specific resin grade with your mold supplier's engineering team based on your drawing and application.
Can they describe, specifically, what a PPAP package looks like for your program — not just say "yes we do PPAP"?
Do they clearly distinguish their actual certifications (e.g., ISO 9001) from customer-requirement support (e.g., IATF 16949 alignment), rather than blurring the two?
Can they show a documented control plan approach, not just a verbal promise of quality control?
Do they have a defined trial process (e.g., T1/T2) and can they explain how additional validation trials would be scoped for your part?
Do they have direct experience with a supplier transition or recovery scenario, in case your program ever needs one?
Can they explain material selection tradeoffs for your specific interior/exterior application rather than pushing a single default resin?
Is their quote turnaround and communication responsiveness fast enough to support your program's decision timeline?
Automotive plastic parts sourcing rewards suppliers who are precise about what they can and can't claim. A toolmaker who tells you plainly "we're ISO 9001 certified, we support PPAP and IATF 16949 customer requirements, and here's exactly how we'd document your part" is giving you something more useful than a vague certification badge on a homepage. At Abery, we'd rather be clear about where we stand than have you find out the hard way mid-program.
